omniplan torrent, first look
Working in OmniPlan Pro, step 2
Working in OmniPlan Pro, step 3
Working in OmniPlan Pro, step 4

Project leads and resource managers reach for OmniPlan Pro when a simple to-do list won’t cut it. It turns rough timelines into clear Gantt charts, splitting work into tasks while keeping an eye on budgets and team availability.

macOS, chip, and language support

  • macOS 12 or later
  • Apple Silicon & Intel both supported
  • Languages Russian, English, German, Spanish, Italian, Simplified Chinese, Korean, Dutch, Portuguese, French, Japanese

What the Pro tier adds

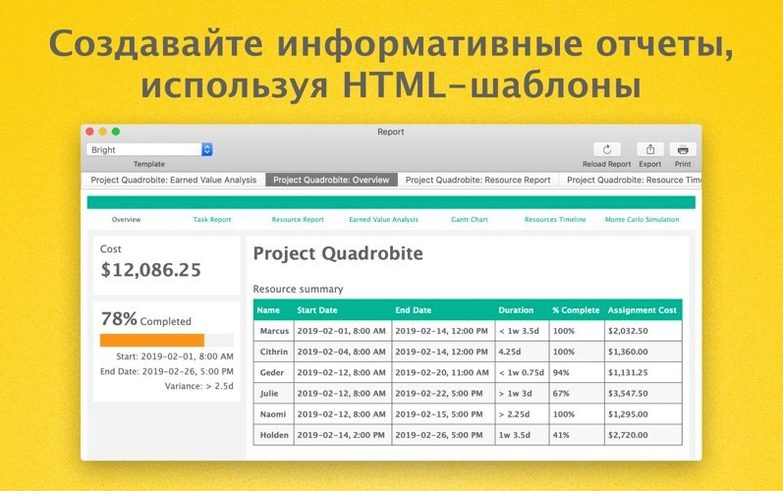

Standard OmniPlan handles task scheduling and progress tracking. The Pro edition layers on multi-project dashboards so you can glance across several timelines at once. HTML reports let you share status updates outside the app, while publishing and subscribing through Omni Sync Server or WebDAV keeps distributed teams in step. You can also push data out to OmniOutliner and OmniGraffle when a plan needs to become a structured list or a visual map.

Curveballs and their fixes

Even a well-built plan can throw a curveball. These are the sticking points that crop up most often—and what to do about them.

Resources overallocating without warning

You assign three tasks to the same designer on the same day and the Gantt chart stays silent. Head into View > Resource Allocation and switch on the timeline that highlights overloads in red. The Pro tier’s automatic levelling can then spread the load—check Project > Level Resources and set a levelling window that matches your sprint length.

Microsoft Project imports that look scrambled

An MPP file lands from a client and the dates shift or custom columns vanish. Before you rework everything, open the Import dashboard and tick Preserve task structure. If milestones still flatten into regular tasks, check that the original file uses a baseline—OmniPlan Pro reads that as an anchor and maps dates more reliably.

Monte Carlo simulation returns oddly wide spreads

When the simulation spits out a completion range spanning six months, the culprit is almost always a single task with a huge effort estimate and no constraints. Pin that task with a Must Start On or Finish No Later Than constraint before re-running. You’ll get a spread that actually informs a decision.

Sync conflicts stacking up

Two people edit the same task while working offline; the next sync brings a pile of Change Tracking alerts. Accept or reject them in batches from the sidebar rather than tackling each one individually. Better still, agree on a rule—whoever owns the resource updates its tasks—before the next sync cycle begins.

Version 4.11 friction cuts

Version 4.11.0 brought two practical improvements that cut down friction during an ordinary workday. The first is broader macOS compatibility, so OmniPlan Pro runs smoothly on recent system updates without font glitches or toolbar oddities that older builds sometimes showed.

The second fix is easy to overlook until you hit the problem: editing a task that has dozens of resources assigned used to lag noticeably. Now the inspector responds without that half-second pause, which matters when you are adjusting a meeting-heavy task across a large department.

Earlier 4.x releases already introduced the multi-project dashboard and Monte Carlo simulation, but 4.11.0 ties them to a more responsive interface on modern Macs. No new buttons to learn—just less waiting.

Default effort estimation method

Fresh out of the disk image, a handful of tweaks make the app fit the way you actually work.

  • Set effort estimation defaults. Open OmniPlan > Settings > Effort Estimation and switch the method to Automatic (Pro) if you want the app to suggest effort based on task type and resource history. Pair it with a confidence level of 80% for early-phase planning.
  • Turn on critical path highlighting. In the Gantt view, click the view options gear and tick Highlight Critical Path. Tasks that directly affect the finish date appear in a distinct colour—useful when a stakeholder asks what can slip and what cannot.
  • Customise the calendar for your region. The default calendar skips weekends, but public holidays vary. Add your country’s holidays in Project > Calendar > Edit Holidays so resource availability reflects real days off.
  • Shrink the auto-save interval. By default the app saves periodically. Drop it to every 5 minutes under Settings > General if you tend to rearrange tasks rapidly and do not want to lose a flurry of changes.

Questions I get

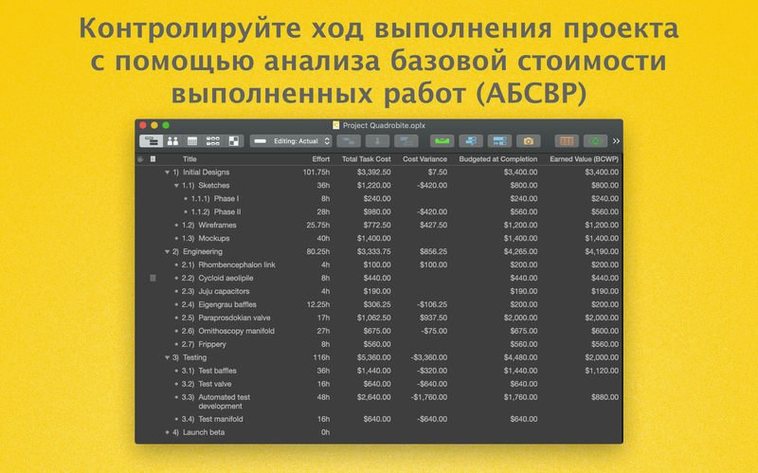

Yes, the Pro version includes a multi-project dashboard that lets you monitor timelines, resources, and progress across several projects in one view.
